Invest in Wheat Ridge

Share Invest in Wheat Ridge on Facebook Share Invest in Wheat Ridge on X (formerly Twitter) Share Invest in Wheat Ridge on Linkedin Email Invest in Wheat Ridge link

Infographic showing progress so far - text version found below

Wheat Ridge moves forward on $75 million bond program with corridor redesigns, sidewalk fixes and stormwater repairs

Survey crews will soon appear on 38th Avenue. Sidewalk dead-ends near schools and parks are slated for repair. And after a string of sinkholes forced more than $2 million in emergency fixes, the city is getting serious about what's underground.

Two years after Wheat Ridge voters approved the $75 million "Next Chapter" bond program, 2026 marks the year the investment starts becoming visible.

The Wheat Ridge City Council recently approved a $636,100 design contract for the 38th Avenue Refresh project, which will overhaul the corridor from Wadsworth Boulevard to Sheridan Boulevard. Conceptual plans are expected in early 2027.

The project aims to improve sidewalks, lighting, landscaping and public gathering spaces while largely preserving the existing roadway configuration. Residents can expect to see survey crews and traffic analysis in the coming months, along with targeted outreach to nearby businesses and property owners.

Further west, design work on the stretch of 38th Avenue between Youngfield Street and Kipling Street is approximately 60% complete. That 1.75-mile corridor is planned for conversion to a two-lane street with dedicated bike lanes and improved pedestrian facilities. The design preserves mature trees, minimizes right-of-way acquisition and targets improvements to specific areas rather than applying changes uniformly across the full corridor.

The city has hired a consultant to design priority sidewalk connections, with construction anticipated in 2026 and 2027. Projects are being selected based on proximity to schools and parks, connectivity to the existing sidewalk network and the feasibility of working around utilities and right-of-way constraints.

Pipe failures have already cost the city more than $2 million in emergency repairs over the past two years, with sinkholes emerging at locations including Independence Street, Miller Street and Hoyt Street. City officials say aging underground infrastructure, much of it under-maintained for decades, is increasingly at risk as fewer opportunities remain for traditional stormwater detention.

Wheat Ridge adopted a Stormwater Master Plan in May 2025 to guide long-term system improvements. Repair work is ongoing, funded through 2J bond dollars.

Voters approved the 2J bond program in 2023. Bonds were issued in late 2024, and the city is now moving from planning into implementation across transportation, drainage and infrastructure projects.

Additional public input opportunities will be announced as projects advance from design into construction.

Infographic showing progress so far - text version found below

Wheat Ridge moves forward on $75 million bond program with corridor redesigns, sidewalk fixes and stormwater repairs

Survey crews will soon appear on 38th Avenue. Sidewalk dead-ends near schools and parks are slated for repair. And after a string of sinkholes forced more than $2 million in emergency fixes, the city is getting serious about what's underground.

Two years after Wheat Ridge voters approved the $75 million "Next Chapter" bond program, 2026 marks the year the investment starts becoming visible.

The Wheat Ridge City Council recently approved a $636,100 design contract for the 38th Avenue Refresh project, which will overhaul the corridor from Wadsworth Boulevard to Sheridan Boulevard. Conceptual plans are expected in early 2027.

The project aims to improve sidewalks, lighting, landscaping and public gathering spaces while largely preserving the existing roadway configuration. Residents can expect to see survey crews and traffic analysis in the coming months, along with targeted outreach to nearby businesses and property owners.

Further west, design work on the stretch of 38th Avenue between Youngfield Street and Kipling Street is approximately 60% complete. That 1.75-mile corridor is planned for conversion to a two-lane street with dedicated bike lanes and improved pedestrian facilities. The design preserves mature trees, minimizes right-of-way acquisition and targets improvements to specific areas rather than applying changes uniformly across the full corridor.

The city has hired a consultant to design priority sidewalk connections, with construction anticipated in 2026 and 2027. Projects are being selected based on proximity to schools and parks, connectivity to the existing sidewalk network and the feasibility of working around utilities and right-of-way constraints.

Pipe failures have already cost the city more than $2 million in emergency repairs over the past two years, with sinkholes emerging at locations including Independence Street, Miller Street and Hoyt Street. City officials say aging underground infrastructure, much of it under-maintained for decades, is increasingly at risk as fewer opportunities remain for traditional stormwater detention.

Wheat Ridge adopted a Stormwater Master Plan in May 2025 to guide long-term system improvements. Repair work is ongoing, funded through 2J bond dollars.

Voters approved the 2J bond program in 2023. Bonds were issued in late 2024, and the city is now moving from planning into implementation across transportation, drainage and infrastructure projects.

Additional public input opportunities will be announced as projects advance from design into construction.

  • 38th Avenue West Improvements (Kipling to Youngfield)

    Share 38th Avenue West Improvements (Kipling to Youngfield) on Facebook Share 38th Avenue West Improvements (Kipling to Youngfield) on X (formerly Twitter) Share 38th Avenue West Improvements (Kipling to Youngfield) on Linkedin Email 38th Avenue West Improvements (Kipling to Youngfield) link

    Project Description

    This project will improve safety and multimodal travel along 1.75 miles of 38th Avenue between Youngfield Street and Kipling Street.

    Improving conditions for people walking, biking, and driving along this corridor has been a long-standing community priority. In 2023, the city launched a planning study to identify improvements that would enhance safety, improve mobility, maintain vehicle access, and address stormwater needs. The recommended design was developed through technical analysis and extensive public input.

    Planned improvements include continuous sidewalks on both sides of the street, dedicated bike lanes in both directions, targeted turn-lane modifications, and upgraded pedestrian crossings. The

    Project Description

    This project will improve safety and multimodal travel along 1.75 miles of 38th Avenue between Youngfield Street and Kipling Street.

    Improving conditions for people walking, biking, and driving along this corridor has been a long-standing community priority. In 2023, the city launched a planning study to identify improvements that would enhance safety, improve mobility, maintain vehicle access, and address stormwater needs. The recommended design was developed through technical analysis and extensive public input.

    Planned improvements include continuous sidewalks on both sides of the street, dedicated bike lanes in both directions, targeted turn-lane modifications, and upgraded pedestrian crossings. The project will generally remain within the existing roadway and right-of-way while maintaining one travel lane in each direction.

    The project also includes three mini-roundabouts at Tabor Court, Parfet Street, and Miller Street to improve safety, calm traffic, and reduce vehicle conflicts. New pedestrian crossings are planned at Quail Street, Lee Street, and Union Court, including marked crosswalks, warning signage, and pedestrian-activated flashing beacons where appropriate.

    In coordination with the project, Xcel Energy is preparing a design that would allow the overhead utility lines to be undergrounded to improve safety and enhance the corridor’s appearance contingent on available funding.

    Rendering of the proposed corridor design showing buffered bike lanes and sidewalks on both sides of W 38th Ave

    Community Support

    Residents, City Council, and city staff have discussed improvements to this corridor for many years. Through the city’s Let’s Talk neighborhood engagement program, residents in the Applewood and Paramount Park neighborhoods identified safer walking and biking conditions along 38th Avenue as a top priority.

    Building on this feedback, the city launched the 38th Avenue West End Improvement Project in 2023. Over the next 18 months, the city conducted three rounds of public engagement, evaluated multiple design alternatives, and worked with residents and stakeholders to develop the preferred design.

    Project Timeline

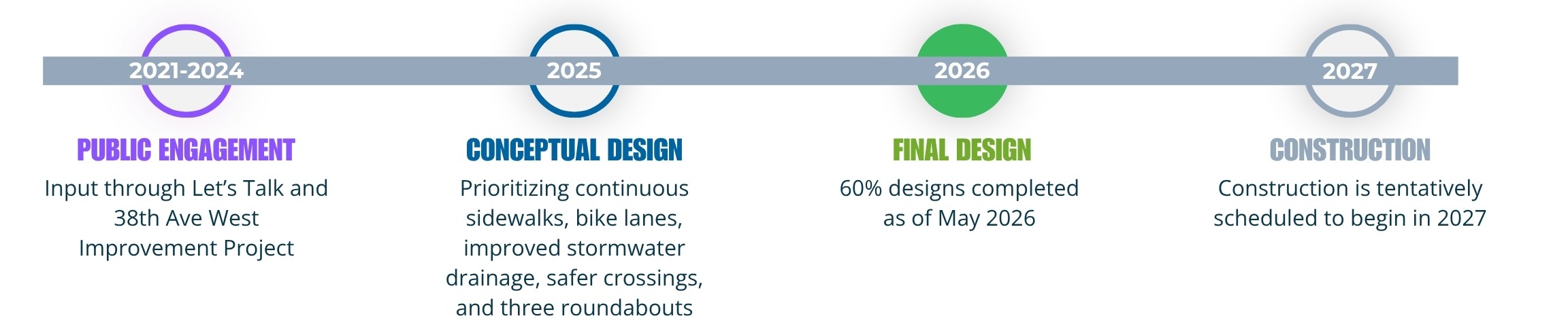

    Project timeline showing we are currently in final design

  • Priority Sidewalk Connections

    Share Priority Sidewalk Connections on Facebook Share Priority Sidewalk Connections on X (formerly Twitter) Share Priority Sidewalk Connections on Linkedin Email Priority Sidewalk Connections link

    Project Description

    This project will design and construct missing sidewalk segments along key pedestrian routes to improve safety, accessibility, and connectivity throughout Wheat Ridge.

    Like many communities, Wheat Ridge’s transportation network was originally designed primarily for cars, leaving gaps in the sidewalk system. Over the past two decades, residents have increasingly identified walking access and safety as community priorities. This project addresses those needs by filling critical sidewalk gaps near schools, parks, and other destinations.

    Round 1 segments, scheduled for construction in 2026, include:

    • Parfet Street (35th Avenue to 3550 Parfet Street)
    • I-70 Frontage Road (Holland Street to Garrison

    Project Description

    This project will design and construct missing sidewalk segments along key pedestrian routes to improve safety, accessibility, and connectivity throughout Wheat Ridge.

    Like many communities, Wheat Ridge’s transportation network was originally designed primarily for cars, leaving gaps in the sidewalk system. Over the past two decades, residents have increasingly identified walking access and safety as community priorities. This project addresses those needs by filling critical sidewalk gaps near schools, parks, and other destinations.

    Round 1 segments, scheduled for construction in 2026, include:

    • Parfet Street (35th Avenue to 3550 Parfet Street)
    • I-70 Frontage Road (Holland Street to Garrison Street)
    • Harlan Street (32nd Avenue to 35th Avenue)

    Round 2 segments, currently in design, include:

    • Miller Street (44th Avenue to 48th Avenue)
    • Pierce Street (29th Avenue to 44th Avenue)
    • 26th Avenue (Oak Street to Paramount Parkway)

    Additional segments will be identified as funding becomes available.

    Community Support

    Improving walking and biking connections has been a community priority for many years. Envision Wheat Ridge, adopted in 2009, identified the need for better multimodal transportation options and led to the city’s first Bicycle and Pedestrian Master Plan. The plan was updated in 2017 to establish a citywide vision for a connected bicycle and pedestrian network.

    Community support for these improvements has continued to grow. In the 2023 Resident Survey, four out of five respondents reported using a bike or pedestrian path during the previous year, while 66% rated the condition of the city’s sidewalks as fair or poor. Similar feedback has been received through the Let’s Talk Resident Engagement Program, the Open Space Management Plan, and other city initiatives.

    Most recently, 86% of respondents during engagement for the 2025 City Plan agreed that creating a connected network of pedestrian and bicycle facilities should be a priority for Wheat Ridge.

    Project Timeline

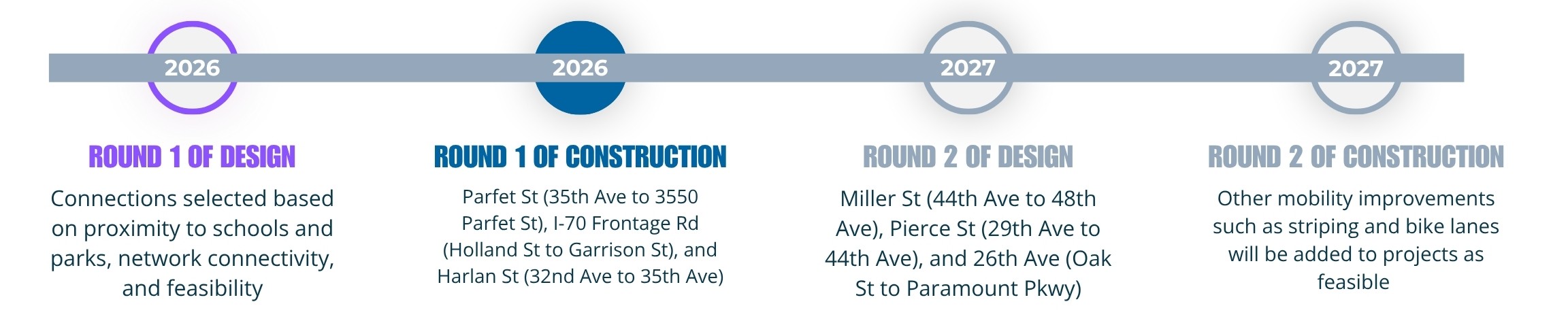

    Timeline showing we are currently in round one of construction

  • 38th Avenue Main Street Refresh (Sheridan to Wadsworth)

    Share 38th Avenue Main Street Refresh (Sheridan to Wadsworth) on Facebook Share 38th Avenue Main Street Refresh (Sheridan to Wadsworth) on X (formerly Twitter) Share 38th Avenue Main Street Refresh (Sheridan to Wadsworth) on Linkedin Email 38th Avenue Main Street Refresh (Sheridan to Wadsworth) link

    Project Description

    This project will advance the long-term vision of 38th Avenue as Wheat Ridge’s Main Street by enhancing safety, connectivity, and placemaking between Sheridan and Wadsworth Boulevards.

    The corridor has been identified as a redevelopment priority for more than a decade. The 2011 38th Avenue Corridor Plan established a vision for transforming the area into a vibrant, walkable destination. Since then, the city has made significant investments, including roadway improvements, streetscape enhancements, zoning updates, intersection reconstruction, and construction of The Green at 38th.

    The Main Street Refresh builds on these investments and moves the community closer to achieving

    Project Description

    This project will advance the long-term vision of 38th Avenue as Wheat Ridge’s Main Street by enhancing safety, connectivity, and placemaking between Sheridan and Wadsworth Boulevards.

    The corridor has been identified as a redevelopment priority for more than a decade. The 2011 38th Avenue Corridor Plan established a vision for transforming the area into a vibrant, walkable destination. Since then, the city has made significant investments, including roadway improvements, streetscape enhancements, zoning updates, intersection reconstruction, and construction of The Green at 38th.

    The Main Street Refresh builds on these investments and moves the community closer to achieving its long-term vision for the corridor.

    Approximately $10 million in 2J Next Chapter funding has been allocated to the project. Conceptual design is underway and focuses on enhancing pedestrian connectivity, lighting, landscaping, and the overall Main Street experience while preserving the existing roadway.

    Community Support

    Community support for a more walkable, vibrant 38th Avenue has been consistently reinforced through public outreach efforts over the past decade, including the Let’s Talk Resident Engagement Program, the Wheat Ridge Prosperity Plan, and the 2025 City Plan.

    During City Plan engagement, 78% of respondents agreed that continuing to develop 38th Avenue as Wheat Ridge’s Main Street should be a priority. Residents also emphasized the importance of placemaking improvements such as enhanced sidewalks, street trees, lighting, crosswalks, public gathering spaces, and other pedestrian-focused amenities.

    The Prosperity Plan echoed these priorities, highlighting strong community support for additional local businesses, walkable commercial districts, and continued investment along key corridors such as 38th Avenue.

    Project Timeline

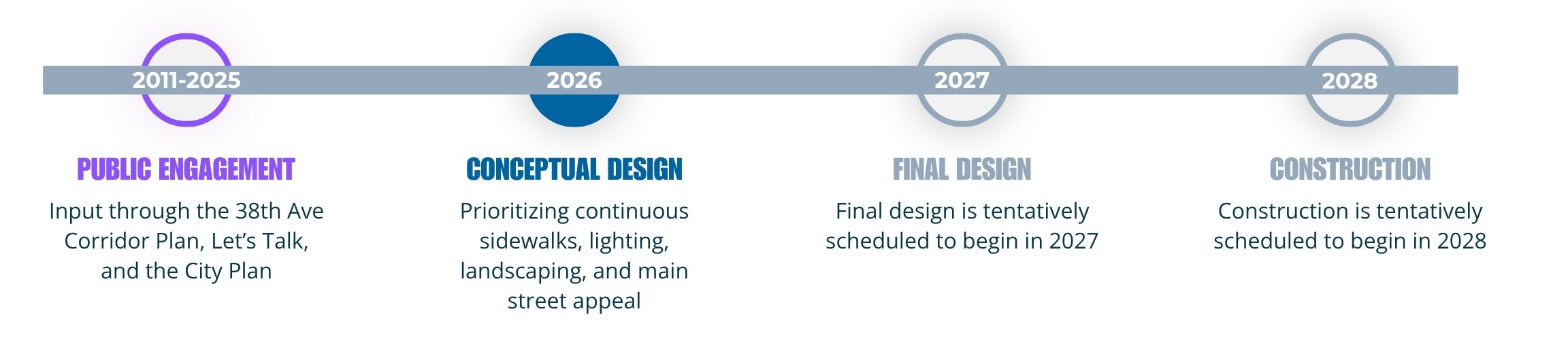

    Project timeline showing we are in the conceptual design phase

    For project specific information and updates, subscribe here.

  • Stormwater System Maintenance

    Share Stormwater System Maintenance on Facebook Share Stormwater System Maintenance on X (formerly Twitter) Share Stormwater System Maintenance on Linkedin Email Stormwater System Maintenance link

    Project Description

    This project addresses critical maintenance needs within Wheat Ridge’s aging stormwater system to reduce flooding risks and protect neighborhoods.

    Much of the city’s stormwater infrastructure was installed during the same period and has received limited reinvestment over time. In 2023, several storm sewer failures required emergency repairs, highlighting the need for ongoing maintenance and replacement.

    Using 2J funds, the city has already repaired sinkholes and replaced 2,303 feet of storm pipe at eight locations during 2025 and 2026. The city will continue monitoring system conditions and making necessary repairs to improve reliability and reduce future risks. Construction crew replacing stormwater pipe

    Community Support

    Project Description

    This project addresses critical maintenance needs within Wheat Ridge’s aging stormwater system to reduce flooding risks and protect neighborhoods.

    Much of the city’s stormwater infrastructure was installed during the same period and has received limited reinvestment over time. In 2023, several storm sewer failures required emergency repairs, highlighting the need for ongoing maintenance and replacement.

    Using 2J funds, the city has already repaired sinkholes and replaced 2,303 feet of storm pipe at eight locations during 2025 and 2026. The city will continue monitoring system conditions and making necessary repairs to improve reliability and reduce future risks. Construction crew replacing stormwater pipe

    Community Support

    Residents consistently identify infrastructure maintenance as an important city responsibility. In the 2023 Resident Survey, nearly 80% of respondents rated stormwater drainage as essential or very important, while fewer residents were satisfied with the current condition of the system.

    In response, the city completed and adopted a Stormwater Master Plan in 2025. The plan was informed by technical analysis and community input and provides a roadmap for future improvements.

    Support for this work was further reinforced during engagement for the 2025 City Plan, where 95% of respondents agreed that proactive infrastructure management, including stormwater maintenance, should be a priority for Wheat Ridge.

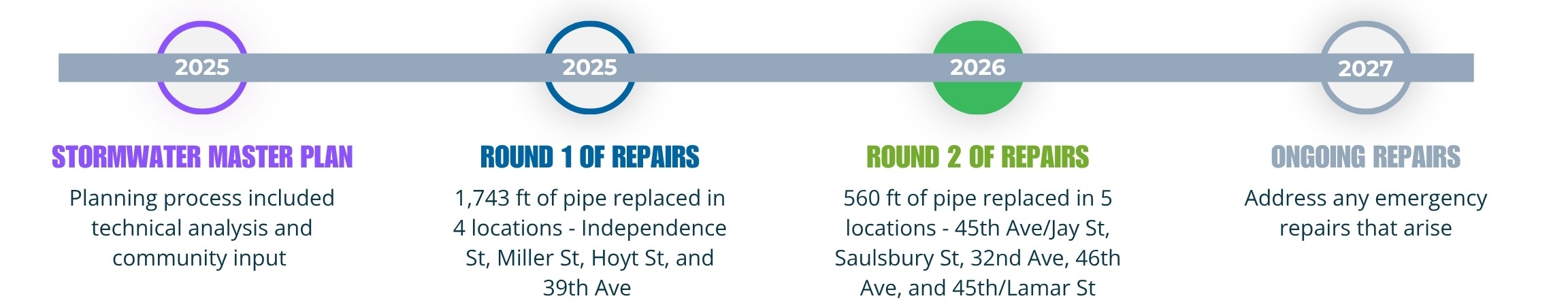

    Project Timeline Project timeline showing we are in round 2 of repairs

  • Wheat Ridge Voters Approve Sales Tax Extension for Capital Improvement Projects

    Share Wheat Ridge Voters Approve Sales Tax Extension for Capital Improvement Projects on Facebook Share Wheat Ridge Voters Approve Sales Tax Extension for Capital Improvement Projects on X (formerly Twitter) Share Wheat Ridge Voters Approve Sales Tax Extension for Capital Improvement Projects on Linkedin Email Wheat Ridge Voters Approve Sales Tax Extension for Capital Improvement Projects link

    In a resounding victory for Wheat Ridge’s next chapter, residents voiced their overwhelming support by approving the extension of the .5 cent sales tax. This significant decision heralds a new era of investment in essential community improvements, including sidewalks, bike lanes, stormwater management, and road enhancements.

    The results of the recent vote were nothing short of extraordinary, with an impressive 70% of voters casting their ballots in favor of extending the sales tax. This enthusiastic endorsement reflects the shared vision of a community committed to enhancing its livability, safety, and overall quality of life.

    The extension

    In a resounding victory for Wheat Ridge’s next chapter, residents voiced their overwhelming support by approving the extension of the .5 cent sales tax. This significant decision heralds a new era of investment in essential community improvements, including sidewalks, bike lanes, stormwater management, and road enhancements.

    The results of the recent vote were nothing short of extraordinary, with an impressive 70% of voters casting their ballots in favor of extending the sales tax. This enthusiastic endorsement reflects the shared vision of a community committed to enhancing its livability, safety, and overall quality of life.

    The extension of the .5 cent sales tax represents a proactive step toward transforming Wheat Ridge into a more walkable and resilient city. The funds generated by this initiative will be strategically allocated to create safer streets, improve connectivity through bike lanes and sidewalks, and bolster the stormwater and drainage systems to reduce flood risks.

    Furthermore, the decision to extend the sales tax was driven by an inclusive and community-driven process. Wheat Ridge residents actively participated in shaping the project lists, ensuring that the most pressing needs and priorities were addressed. The campaign also involved extensive outreach efforts, such as Let's Talk and a resident survey, that encouraged meaningful input from all members of the community.

    Mayor Bud Starker expressed profound gratitude for the support of the voters, stating, "This is a pivotal moment for Wheat Ridge. The overwhelming approval of the sales tax extension reflects our community's commitment to progress and its belief in the transformative power of our collective efforts. We are excited to embark on these important projects that will elevate Wheat Ridge to new heights."

    The approved extension is expected to fund a series of capital improvement projects over the next five to eight years, with residents' feedback incorporated into every step of the process. Wheat Ridge is now poised to enter a new chapter of growth, resilience, and community engagement, thanks to the resounding support of its residents.

    As the city eagerly awaits the commencement of these vital projects, it is evident that the future of Wheat Ridge shines brighter than ever. The extension of the .5 cent sales tax is not just a financial decision; it is a reflection of the shared commitment of a community determined to make Wheat Ridge an even better place to live, work, and thrive.

  • How Were the Projects on the Ballot Decided?

    Share How Were the Projects on the Ballot Decided? on Facebook Share How Were the Projects on the Ballot Decided? on X (formerly Twitter) Share How Were the Projects on the Ballot Decided? on Linkedin Email How Were the Projects on the Ballot Decided? link

    The unfunded capital improvement projects being approved by voters in the extension of the .5 cent sales tax were developed as a direct result from resident feedback and deliberate planning.

    Planning and outreach efforts included the following:

    NRS Update (2019)

    The Neighborhood Revitalization Strategy (NRS) began in the early 2000s with the goal of facilitating a healthy housing market, attracting commercial investment, and supporting a vibrant community. The 2019 NRS was a report card or checkup on that progress. The city looked at the data and took the temperature of residents.

    The NRS raised the bar in terms of public

    The unfunded capital improvement projects being approved by voters in the extension of the .5 cent sales tax were developed as a direct result from resident feedback and deliberate planning.

    Planning and outreach efforts included the following:

    NRS Update (2019)

    The Neighborhood Revitalization Strategy (NRS) began in the early 2000s with the goal of facilitating a healthy housing market, attracting commercial investment, and supporting a vibrant community. The 2019 NRS was a report card or checkup on that progress. The city looked at the data and took the temperature of residents.

    The NRS raised the bar in terms of public engagement. Led by the steering committee, feedback relied on small group meeting, one-on-one conversations, open houses, and 1000 survey responses.

    More details here: https://www.ci.wheatridge.co.us/276/NRS-Update

    Resident Survey (2021)

    Currently, the city is soliciting feedback from randomly selected residents for the 2023 Resident Survey. The 2021 survey, assessed resident satisfaction with community characteristics and amenities, evaluated Wheat Ridge local government and employees, and helped the city further understand resident’s priorities regarding city government services.

    Learn more here: https://www.ci.wheatridge.co.us/258/Resident-Survey

    Let’s Talk (2021-2023)

    This program documents neighborhood-specific issues and opportunities by collecting resident feedback through community meetings, neighborhood pop-ups, and surveys. The process asks open-ended questions and builds trust with residents. So far over 1,500 residents have engaged.

    Goals established at the onset:

    • Develop a thorough, well documented understanding of the issues and opportunities at the neighborhood level

    • Build trust between city staff and neighborhoods through demonstration that the city is listening and being responsive;

    • Better empower neighborhoods to take initiative and work effectively with the city for positive outcomes that respond to neighborhood changes;

    • Ensure that all neighborhoods in the city have an opportunity for focused listening and responsive actions from the city within approximately two year cycles; and

    • Ensure that the feedback received during the engagement "blitz" is robust and represents a diversity of opinions in each neighborhood.

    Learn more about the Let's Talk Program here: https://whatsupwheatridge.com/lets-talk

    Lutheran Subarea Plan (2022)

    The Lutheran Legacy Campus master plan document reflects the vision of the community and was created using a market study to ensure that the plan is realistic and has the best possible chance of coming to pass. The document outlines a framework for future development. It is not a site plan, it does not prescribe specific uses, nor is it a zoning document. It describes what the community likes and dislikes, it articulates goals and desires, and it creates guardrails for future development. Ultimately, it communicates to future owners the community’s expectations, without which the property could be developed in a way that runs counter to community wishes. To review the plan please visit: https://www.ci.wheatridge.co.us/1788/Lutheran-Campus

    Affordable Housing Strategy (2023)

    The Wheat Ridge City Council adopted the Affordable Housing Strategy and Action Plan on January 9, 2023, as a guiding document to address housing affordability in Wheat Ridge. The process started in early 2022 and included opportunities for public input, discussions with over 20 housing developers, and four City Council discussions in 2022. The plan can be viewed here: https://whatsupwheatridge.com/housing

    44th Avenue Subarea Plan (2023)

    This plan includes land use recommendations and identifies areas appropriate for commercial, mixed use, and residential development. Through public input it was identified there is a clear desire to protect the character of the existing lower density neighborhoods, a willingness for townhome and newer development on the corridor, and an understanding that attracting retail and dining options will require more rooftops.

    The most well supported recommendations relate to mobility improvements including, wider, safer, shaded, continuous sidewalk, improved access within and into the corridor, improved tabor bridge, and improved access to the creek.

    The full plan can be viewed here: https://www.ci.wheatridge.co.us/1821/44th-Avenue

    Open Space Management Plan (2023)

    The purpose of the Open Space Management Plan is to create a bold vision for the future of the Wheat Ridge Greenbelt, Clear Creek Trail, and open space assets. It balances recreation use with resource protection, while incorporating strategies for long-term sustainability and stewardship.

    The plan incorporated community engagement, an evaluation of existing conditions and future opportunities, and the identification of alternatives and solutions to existing challenges.

    For more information visit: https://whatsupwheatridge.com/open-space-management-plan-2022-update

    Facilities Master Plan (2023)

    (I'm not able to find this) Results from this internal document have found that city own facility needs have exceeded available space, many components are at or beyond expected service life, improvements will require significant financial investment, and there is opportunity to reimagine spaces.

    Major Themes Developed As a Result of the Above

    Corridors

    The City of Wheat Ridge has repeatedly heard that corridors are an issue requiring attention. Specifically, there’s interest in giving attention to local streets—not state highways—to 44th and 38th and Youngfield, 32nd and 29th.

    It’s interesting because in the NRS survey in early 2019 among these corridors, 38th Avenue east of Wadsworth received the highest marks among other primary corridor segments, but the neighborhoods east of Wadsworth certainly expressed through Let’s Talk a sense that the Main Street vision on 38th Avenue still feels incomplete.

    The segment west of Wadsworth has long been a priority across a few of these efforts. The 38 West or 38 Walk project will come to Council for contract award and budget supplemental to kick off a conceptual design process.

    The NRS survey ranked 44th Avenue as second to worst among the corridors. There are a range of improvements that have come up, both linear and targeted including, conditions east to west on 44th and even on the frontage road, improved crosswalks on 44th, improved crossing of i-70—the tabor street bridge as long been mentioned as a barrier with a lack of bike/ped facilities, and targeted medians near the truck stop.

    Youngfield – not only aesthetic improvements for which design is underway, but sidewalk improvements along Yougnfield – a sense that it connects or could connect the neighborhood to Applewood Village, CCC, and the creek in a better way.

    Map of Current Primary Corridors

    Mobility

    We’re seeing interest city wide and through Let’s Talk feedback in pedestrian mobility access for localized projects. While there is certainly some disagreement at the local street or block level as to whether there should be sidewalks, we see significantly more consensus in public feedback when we take a broader view.

    There is a common theme in a desire for improved sidewalk connections city wide --- particularly on collectors and arterials. This has been expressed through the bike ped master plan and in Let’s Talk.

    During the Lutheran plan, that was a key conversation related to surrounding streets, including Dudley and 32nd Avenue – part of the recommendation for Transportation Demand Management in the Lutheran area is to invest in multimodal infrastructure.

    Floodplain & Drainage

    One of the highest priority areas for floodplain mitigation is near the Clearvale neighborhood. This area has many homes within the floodway and the 100-year floodplain which not only raises insurance rates, but also inhibits investment in properties.

    With the current mapping, a project could remove 48 houses from the floodway and an additional 55 houses and seven multifamily buildings from the floodplain.

    During the Anderson Park Let’s Talk Blitz the highest ranked action item was to Improve Clear Creek North of 44th Avenue to Reduce Flood Impacts on Property. The same project was raised as part of 44th planning.

    Parks & Open Space

    Results from parks and open space studies and resident impacts concluded that general access to Clear Creek Greenbelt be increased. This includes formalizing some social trails and installing a trail head at Otis St. A need for a crosswalk at Kipling to the Clear Creek Trail was identified. Resident feedback also stressed the need to balance amenities with access, habitat restoration.

    Public Facilities

    Identified projects include a Parks and Recreation Center expansion to support new fitness/gym facilities and a additional space for camps. This plan does not include an additional pool. It also identified a need for a reimagined City Hall, a cultural center, and a public works building to support materials and vehicle storage.

  • Infographic - ADA version

    Share Infographic - ADA version on Facebook Share Infographic - ADA version on X (formerly Twitter) Share Infographic - ADA version on Linkedin Email Infographic - ADA version link

    Below is the text version of the 2J infographic from above.

    Building a better Wheat Ridge.

    Investing in safer streets, connected neighborhoods, and a stronger future.

    2023 - Voters approved the $75 million "Next Chapter" bond program.

    2024 - After waiting for favorable interest rates, bonds were issued.

    A promise for our community: $75 million for safer streets, improved stormwater infrastructure, connected neighborhoods.

    Progress so far (2025-2026).

    Delivering today. Preparing for tomorrow.

    Making an impact today.

    • 2,303 feet of storm pipe relaced at 8 locations
    • 5.5 miles of city street repaved
    • 5,786 feet of sidewalk improved
    • 13 ADA ramps installed

    Below is the text version of the 2J infographic from above.

    Building a better Wheat Ridge.

    Investing in safer streets, connected neighborhoods, and a stronger future.

    2023 - Voters approved the $75 million "Next Chapter" bond program.

    2024 - After waiting for favorable interest rates, bonds were issued.

    A promise for our community: $75 million for safer streets, improved stormwater infrastructure, connected neighborhoods.

    Progress so far (2025-2026).

    Delivering today. Preparing for tomorrow.

    Making an impact today.

    • 2,303 feet of storm pipe relaced at 8 locations
    • 5.5 miles of city street repaved
    • 5,786 feet of sidewalk improved
    • 13 ADA ramps installed

    2026 Focus

    • 38th Ave West (Kipling to Youngfield) - Currently in final design, this project will close sidewalk gaps, improve stormwater drainage, add bike lanes, and three roundabouts along the 1.75-mile corridor.
    • Intersection Improvements - Traffic studies for 44th Ave & Tabor St and 44th Ave & Eldrigdge St are underway. The 44th / Tabor intersection new traffic signal will be bid for construction in late spring 2026.
    • Emergency Stormwater Repairs - Ongoing repairs to stormwater infrastructure will be made to reduce flooding risks and protect our neighborhoods.
    • 38th Ave Main Street Refresh (Sheridan to Wadsworth) - Conceptual design is underway to enhance pedestrian connectivity, lighting, landscaping, and main street appeal, while preserving the existing roadway.
    • Priority Sidewalk Connections - Consultant hired to design priority connections. Projects selected based on proximity to schools and parks, network connectivity, and feasibility. First phase to include: Parfet St (35th Ave to 3550 Parfet), I-70 Frontage Road (Holland to Garrison), and Harlan St (32nd Ave to 35th Ave) will be built this year. Designs underway for sections of Pierce St, 26th Ave, and Miller St.
Page last updated: 10 Aug 2026, 11:48 AM
